How RapidCrete Executed Precision PT Slab Removal in an Active High-Rise Without Disruption

Introduction

Concrete removal inside an active high-rise is never just about cutting concrete. It is about precision, planning, and complete control over risk.

In this project, RapidCrete was tasked with removing over 100 tons of suspended slab concrete between post-tension cables across three levels of a fully operational residential tower in downtown Vancouver. The work had to be done without disrupting occupants, without compromising structural integrity, and under strict environmental controls.

Project Overview

  • Project Type: Residential High-Rise

  • Location: Downtown Vancouver

  • Scope:

    • Shoring engineering

    • Work plan development and submission

    • Concrete cutting and removal

    • Disposal of suspended slabs on Levels 29, 30, and 31

  • Volume Removed: 100+ tons

The objective was to create three vertically aligned slab openings for a new internal staircase.

The Challenge

This project combined multiple high-risk conditions:

  • The building was fully active and occupied

  • Work had to be completed during night shifts

  • Strict dust, slurry, and silica control was required to protect the building

  • Elevator limitations made removal logistics complex

  • The slabs were post-tensioned, meaning any error could lead to serious structural consequences

This was not just a cutting job. It required full coordination between engineering, planning, and execution.

Why This Was Complex

Precision in Post-Tension Slabs

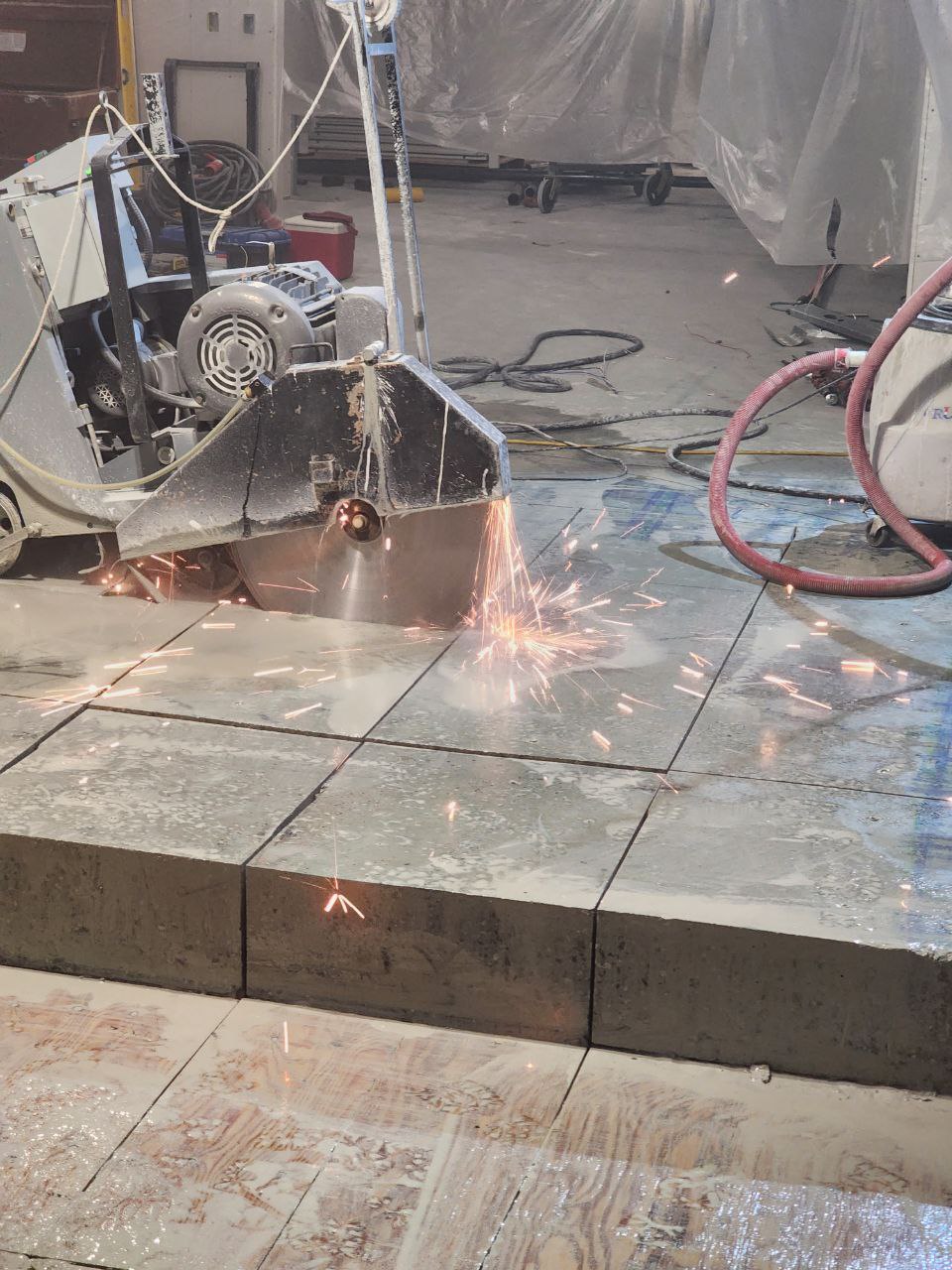

The slab was post-tensioned, and cutting had to be performed exactly between tensioned cables.

  • GPR scanning was used to locate cables

  • No margin for error in cutting paths

  • Openings across three floors had to align perfectly

To achieve this, pilot core drilling was performed at the corners to ensure vertical alignment before full cutting began.

Engineering and Load Control

Removing large sections of suspended slab required careful structural management.

  • Full shoring design and engineering was required

  • Cutting and removal had to follow a strict sequence

  • Load had to remain balanced on the shoring system at all times

Full Responsibility Under One Sub-Contractor

RapidCrete was responsible for the entire scope:

  • Hiring and coordinating shoring engineering

  • Developing the work plan

  • Securing approvals

  • Executing the work

All approvals were obtained from the property manager, general contractor, and other stakeholders before work began.

Detailed Planning and Coordination

A comprehensive work plan was submitted that included:

  • Safety procedures

  • Technical execution details

  • Step-by-step sequencing

  • Day and night scheduling

Every aspect of the job was planned before execution started.

Initial Assessment and Adjustments

The project progressed largely as planned due to an accurate upfront assessment.

One challenge identified during scanning was rebar congestion in certain areas. This required adjustments to cutting locations and sequencing to avoid cutting directly through rebar.

These changes were made early and did not impact the overall schedule.

The RapidCrete Approach

Instead of providing only cutting services, RapidCrete delivered a complete solution.

The client was given:

  • Multiple execution options

  • A clear and detailed plan

  • Full visibility into sequencing and safety

By handling everything from engineering to execution, RapidCrete removed the need for multiple subcontractors and simplified accountability.

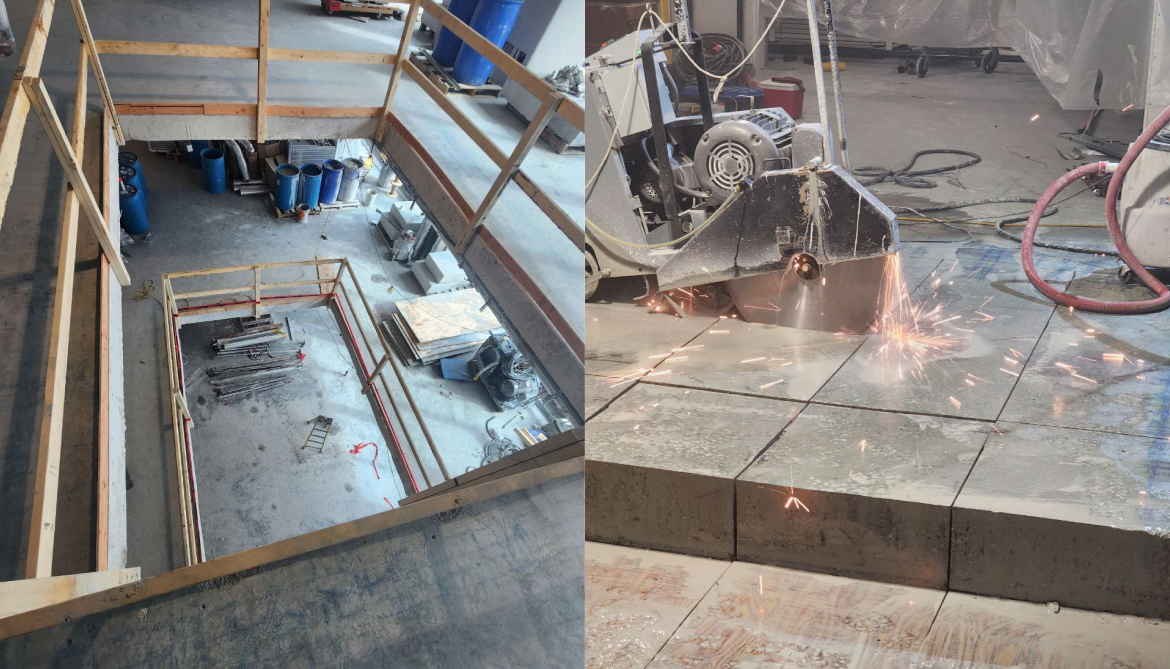

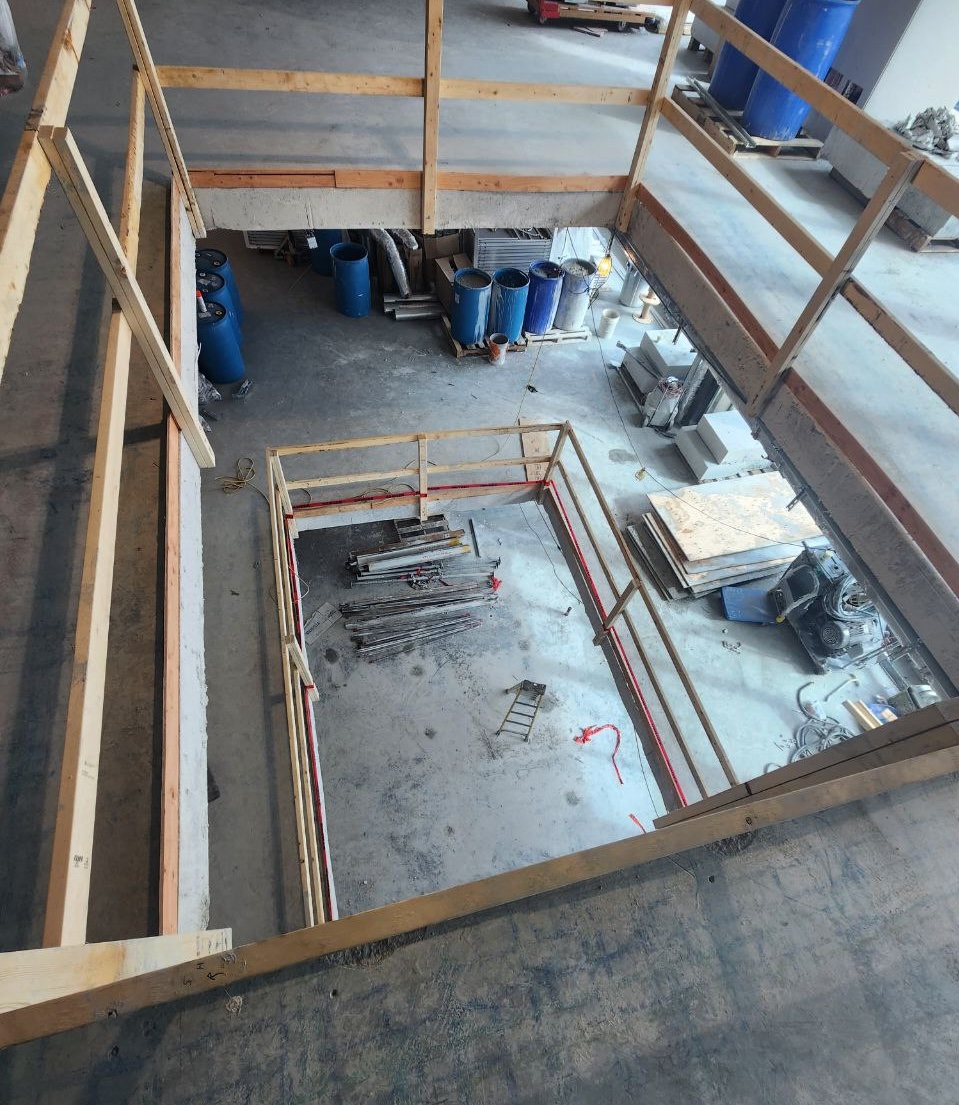

Execution

The project followed a structured process:

  1. Site review and internal planning

  2. Development of cutting sequence and block sizing

  3. Shoring design and engineering coordination

  4. Submission of a detailed work plan

  5. Approval from all stakeholders

  6. Night shift execution according to plan

The work was completed without deviation from the approved plan.

Results and Impact

  • Over 100 tons of concrete removed safely

  • Zero disruption to building operations

  • All work completed according to plan

  • Environmental controls maintained throughout

The outcome extended beyond the project itself.

The property manager, satisfied with the execution, introduced RapidCrete to other unit owners in the building, resulting in additional work within the same high-rise.

Key Takeaways

1. One Contractor, Full Control

Managing the full scope under one contractor simplifies coordination, reduces risk, and creates clear accountability.

2. In-House Capability Matters

Having scanning, cutting, shoring, and disposal capabilities in-house allows for better control, faster decisions, and higher confidence for the client.

3. Planning Drives Execution

When planning is done correctly, execution becomes predictable. This project was successful because every step was defined before work began.

Closing

Projects like this require more than technical skill. They require ownership, coordination, and precision at every stage.

RapidCrete continues to support complex structural work by delivering complete solutions that clients can rely on.
